Aalo Atomics logo

Aalo Atomics

BActiveFounded 2023🇺🇸🇦Austin, Texas
CEO

Matt Loszak

Data verified as of Jul 17, 2026

Summary

Aalo Atomics is an Austin-based nuclear startup founded in 2023 by CEO Matt Loszak and CTO Yasir Arafat (former lead of INL's MARVEL microreactor) to mass-manufacture sodium-cooled reactors purpose-built for AI data centers. Its product line pairs the factory-built 10 MWe Aalo-1 reactor with the Aalo Pod, a 50 MWe 'extra modular' plant that clusters five reactors and is designed to install in months. Selected for the DOE's Reactor Pilot Program in August 2025, Aalo brought its Aalo-X Critical Test Reactor at Idaho National Laboratory to first criticality on July 4, 2026 — the fourth DOE-authorized advanced reactor to meet Executive Order 14301's deadline, less than eight months after groundbreaking. The company has raised over $300 million, including a $100M Series B led by Valor Equity Partners, and operates a 40,000 sq ft pilot factory in Austin with plans for a one-million-square-foot mass-production plant. Next up is Project Ascension: a commercial-scale reactor on the Aalo-X campus intended to power a co-located data center in 2027, with a long-term target of 3¢/kWh electricity.

Main Products

Aalo-1

Aalo-1

In Development

A factory-mass-manufactured 10 MWe (30 MWt) sodium-cooled, graphite-moderated reactor running on low-enriched uranium-dioxide fuel at near-atmospheric pressure. Sized to ship by truck, with fully passive shutdown and 72+ hour passive decay-heat removal; five Aalo-1s power each Aalo Pod.

Full-scale core design demonstrated criticality in the Aalo-X Critical Test Reactor at INL on July 4, 2026; commercial units will deploy in 50 MWe Aalo Pods.

Output10 MWe / 30 MWt
CoolantLiquid sodium (near-atmospheric pressure)
FuelUO₂ ceramic, LEU+ (5–8%)
Aalo Pod

Aalo Pod

In Development

Aalo's 'extra modular' power plant for AI data centers: five Aalo-1 reactors with shared turbines producing 50 MWe on the footprint of a few tennis courts. Built from factory-manufactured truck-sized modules, designed to install in months and to phase maintenance so the plant is never fully offline.

First commercial Pod construction is planned to begin in 2028, with availability targeted for Q3 2028; no launch customer has been publicly announced yet.

Capacity50 MWe
Reactors per Pod5× Aalo-1
Target availabilityQ3 2028
Aalo-X

Aalo-X

In Development

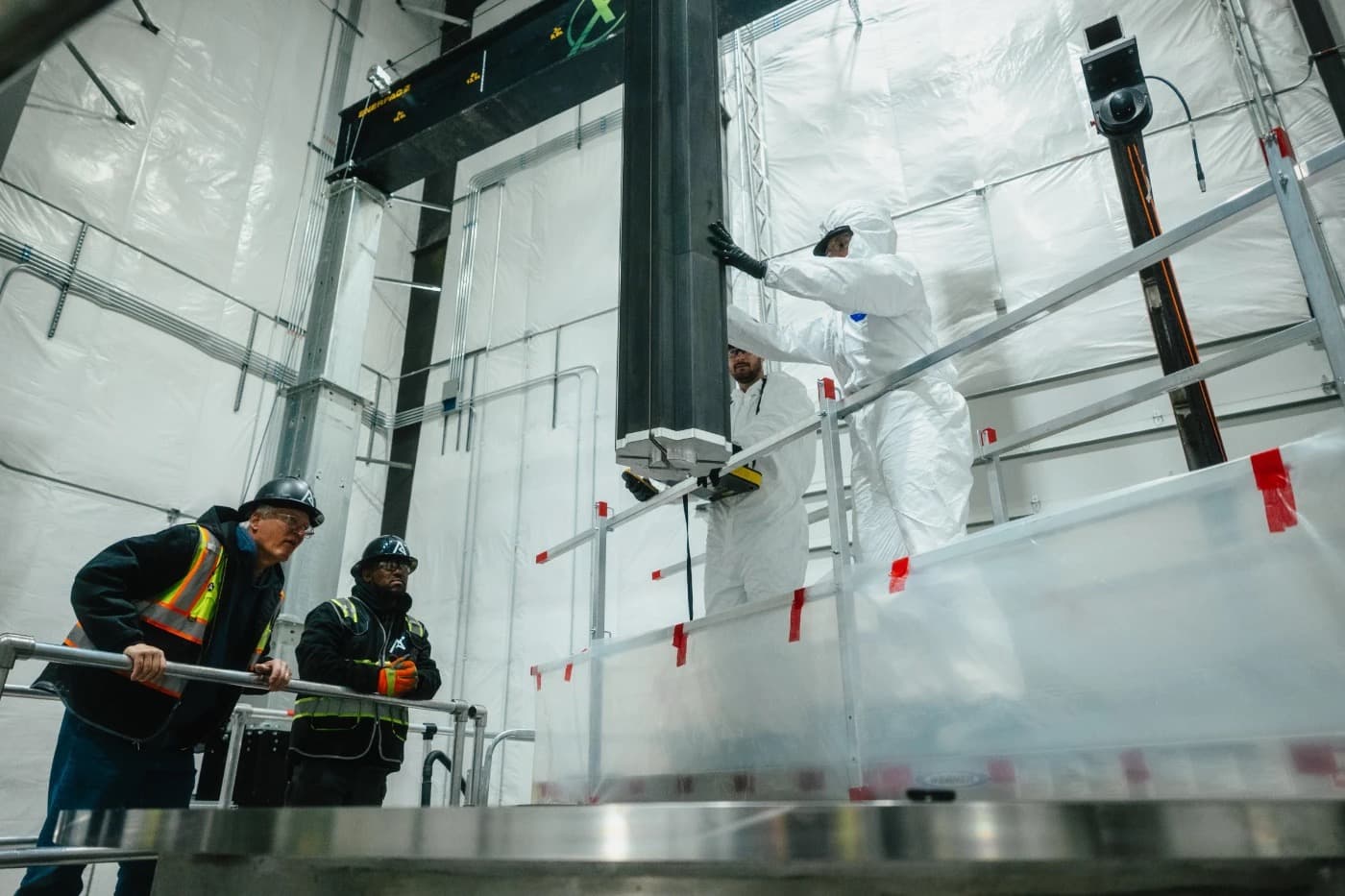

Aalo's experimental reactor campus at Idaho National Laboratory, built under the DOE Reactor Pilot Program. Its sodium-cooled Critical Test Reactor — a full-scale Aalo-1 core with 13 uranium-dioxide fuel assemblies — reached first criticality on July 4, 2026; the campus's follow-on Project Ascension reactor is intended to generate 10 MWe and power a co-located experimental data center.

Critical Test Reactor achieved criticality July 4, 2026 — the fourth DOE-authorized advanced reactor to meet the Executive Order 14301 deadline — less than eight months after groundbreaking. Project Ascension earthwork is complete and first concrete is underway.

First criticalityJuly 4, 2026
Groundbreaking to criticalityUnder 8 months
Planned output10 MWe with co-located data center

What's Next

Complete the Project Ascension reactor at INL

Finish construction of the second, commercial-scale reactor on the Aalo-X campus — excavation and earthwork were complete by criticality day and first-concrete preparation is underway, with reactor completion targeted by end of 2026.

Q4 2026

Commission the Aalo-0 sodium test prototype

Bring the full-scale non-nuclear sodium test prototype into commissioning in Austin to validate thermal-hydraulic performance ahead of commercial reactor production.

Q4 2026

Generate power for a co-located data center at INL

Bring the Aalo-X campus to power operations so Project Ascension's 10 MWe reactor can feed an on-site experimental data center — the first nuclear plant purpose-paired with a data center.

2027

Begin construction of the first commercial Aalo Pod

Start building the first commercial 50 MWe Aalo Pod for a data-center customer, with construction planned to begin in 2028 and availability targeted for Q3 2028.

2028

Ramp the one-million-square-foot reactor gigafactory

Expand from the 40,000 sq ft Austin pilot factory to a one-million-square-foot mass-production plant capable of roughly a gigawatt of reactors per year, ramping in 2030.

2030

Operations & Revenue

StatusPre-revenue

Venture-funded reactor developer: its first reactor, the Aalo-X Critical Test Reactor, achieved criticality at Idaho National Laboratory in July 2026, but no commercial plant is operating yet. First revenue is expected from Aalo Pod power sales to data-center customers.

Pipeline & Contracts

Aalo Pod power sales (planned)

Behind-the-meter electricity from 50 MWe Aalo Pods co-located with AI data centers, targeting 3¢/kWh at scale; first commercial Pods are slated for construction starting in 2028.

Factory-built reactor manufacturing (planned)

Assembly-line production of Aalo-1 reactors and plant modules from its Austin factory — currently 40,000 sq ft, with a planned one-million-square-foot facility to reach gigawatt-per-year output.

DOE programs and demonstration work

Work under the DOE Reactor Pilot Program: Aalo signed an Other Transaction Agreement with DOE in September 2025, making it a direct DOE contractor for the Aalo-X demonstration campus at Idaho National Laboratory.

Key Metrics

Employees

~200

Est. Annual Revenue

Pre-revenue

Total funding

$300M+

Employees

~200

Aalo Pod output

50 MWe

Founding to criticality

Under 3 years

Target power cost

3¢/kWh

Timeline

2026DOE approves Aalo-X safety analysis; fuel delivered

DOE-Idaho approved the Documented Safety Analysis for the Aalo-X Critical Test Reactor (May 2026); fuel rods fabricated by Global Nuclear Fuel from Urenco-enriched uranium were delivered in April 2026.

2026Aalo-X Critical Test Reactor achieves first criticality at INL

At 12:20 a.m. MT on July 4, 2026, Aalo's sodium-cooled, graphite-moderated Critical Test Reactor reached a self-sustaining chain reaction — the fourth DOE-authorized advanced reactor to go critical under Executive Order 14301, less than eight months after groundbreaking and under three years from the company's founding.

2025Pilot factory and full-scale non-nuclear prototype completed

Completed a 40,000 sq ft pilot factory in Austin and finished Aalo-0, a full-scale non-nuclear prototype of its reactor, ahead of nuclear construction.

2025Selected for DOE Reactor Pilot Program

Named one of the initial companies in the DOE's fast-track Reactor Pilot Program (August 12, 2025) to build the Aalo-X experimental reactor at Idaho National Laboratory under DOE authorization, targeting criticality by July 4, 2026; groundbreaking followed within weeks.

2025$100M Series B led by Valor Equity Partners

Raised a $100M Series B (August 19, 2025) to build Aalo-X and pair it with an experimental co-located data center, with participation from Hitachi Ventures, NRG Energy, Tishman Speyer and others.

2025First U.S. commercial enriched-uranium supply contract (Urenco)

Became the first U.S. reactor company with a contract for commercial delivery of enriched uranium, signing a fuel supply deal with Urenco (September 2025) to feed its factory-built reactors at scale.

2024$27M Series A

Closed a $27M Series A (August 2024) from investors including Fifty Years, Valor Equity Partners, Harpoon Ventures, Crosscut and Alumni Ventures to develop the Aalo-1 reactor.

2023Founded in Austin; $6.26M seed round

Matt Loszak and Yasir Arafat found Aalo Atomics to mass-produce small sodium-cooled fission reactors, raising a $6.26M seed led by Fifty Years with participation from Valor Equity Partners.

Funding

Cumulative disclosed raise · dated rounds

$200M$400M$600M202420252026$433M raised
RoundDateAmountInvestorsSource
Seed2023$6.26MFifty Years (lead), Valor Equity Partners, angel investors
Series AAugust 2024$27MFifty Years, Valor Equity Partners, Harpoon Ventures, Crosscut, SNR, Alumni Ventures, Nucleation Capital
Series BAugust 2025$100MValor Equity Partners (lead), Fine Structure Ventures, Hitachi Ventures, NRG Energy, Tishman Speyer, Kindred Ventures, 50Y, Harpoon Ventures, Crescent Enterprises, Crosscut, MCJ, Nucleation Capital, others
Series B extensionMay 2026Undisclosed (company reports $300M+ raised to date)Undisclosed; Ontario Teachers' Pension Plan holds a board seat as of mid-2026
