Form Energy logo

Form Energy

PrivateFounded 2017🇺🇸Somerville, MassachusettsCEO Mateo Jaramillo

Form Energy, founded in 2017 by former Tesla energy chief Mateo Jaramillo, MIT professor Yet-Ming Chiang, Ted Wiley, Billy Woodford and Marco Ferrara, is building the storage technology that lithium-ion cannot economically reach: a 100-hour battery.

Latest update Oct 4, 2026

01

Overview

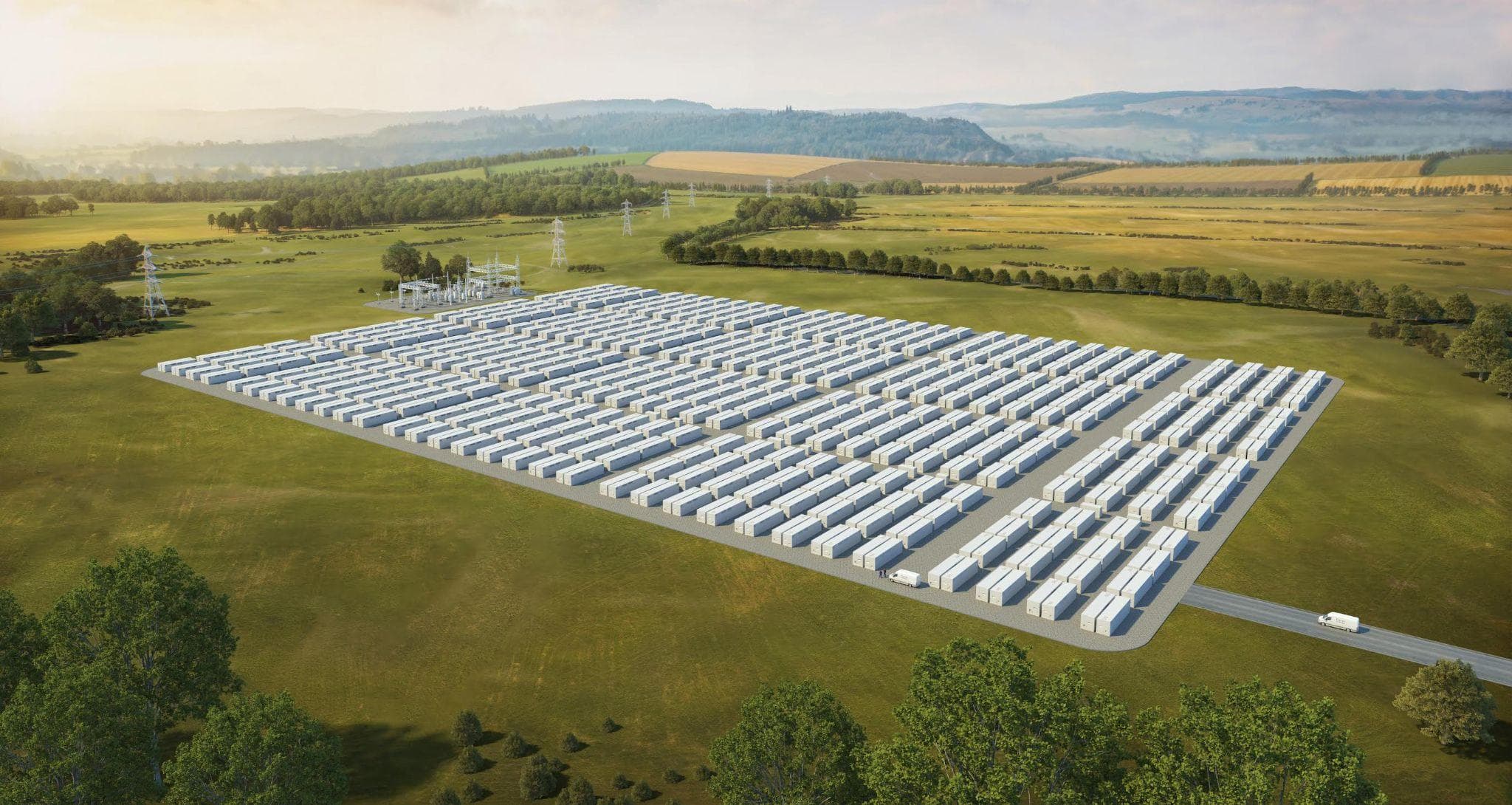

Its iron-air cells run on reversible rusting, oxidising iron with air from the atmosphere to discharge and converting the rust back to iron to charge, using materials so cheap the company claims a cost per kilowatt-hour a fraction of lithium-ion's. That makes multi-day storage viable, the duration Jaramillo argues is where batteries stop shaving peaks and start replacing thermal power plants. The company manufactures at Form Factory 1, a 550,000 square-foot plant in Weirton, West Virginia built on a former tin mill site, now in production with more than 450 people on site; a September 9, 2026 technician hiring sprint is filling day and night shifts as output ramps. The first commercial system, a 1.5 MW / 150 MWh project with Great River Energy in Cambridge, Minnesota, is still unfinished: Great River Energy's May 2026 integrated resource plan said structures and balance of plant were substantially complete, remaining modules were still awaited, and commercial operation is targeted by the end of 2026. A July 2026 independent site visit found the pad still mostly empty after the initial late-2025 enclosure install. Demand is now driven as much by AI data centers as by utilities. Form has more than 80 GWh of commercial projects under agreement, including a 300 MW / 30 GWh system with Google and Xcel Energy that Xcel calls the largest battery project by energy capacity ever announced, a 12 GWh capacity agreement with Crusoe for AI data centers starting in 2027, and its first deployment outside the US, a 1 GWh project with FuturEnergy Ireland. A separate 85 MW / 8.5 GWh project at a former mill in Lincoln, Maine, backed by nearly $150M in DOE grid-resilience funds, is slated to start construction in 2028. Form has raised more than $2B, including a $750M Series G led by T. Rowe Price that closed in August 2026 (a down round at about $1.75B pre-money), added Wes Sloan (ex-Panasonic Energy Nevada) as COO and Navneet Govil as CFO, has picked JPMorgan and Jefferies to lead its IPO, and plans to go public in 2027. Jaramillo has said the company expects its first meaningful revenues in 2026 and that factory output is allocated into late 2028 or 2029.

formenergy.comUpdated Sep 15, 2026

02

What's next10

  1. Late 2026

    Bring the Dominion Energy Darbytown iron-air pilot online

    An 8.94 MW iron-air pilot at Dominion Energy's Darbytown Power Station in Henrico County, Virginia, approved by the Virginia State Corporation Commission in May 2024, is targeted to be operational by late 2026 alongside a separate zinc-hybrid pilot from Eos Energy at Virginia State University.

  2. End of 2026

    Bring the first commercial iron-air system online in Minnesota

    The 1.5 MW / 150 MWh Cambridge Energy Storage Project with Great River Energy is the first commercial deployment of iron-air anywhere. Great River Energy's May 2026 integrated resource plan said structures and balance of plant were substantially complete, remaining modules were still awaited, and commercial operation is targeted by the end of 2026. A July 2026 independent site visit found no additional visible work after the initial late-2025 enclosure install. Form's about page still describes a 2025 demonstration at the site with the full project due in 2026. That end-of-2026 COD is the first real-world proof that a 100-hour battery works on a live grid.

  3. End of 2026

    Confirm Cambridge 1.5 MW / 150 MWh commercial operation

  4. 2027

    Begin Crusoe deliveries for AI data centers

    The 12 GWh strategic capacity agreement with Crusoe starts delivering in 2027, with every system built at Form Factory 1 in Weirton. It is the first of Form's AI-driven agreements to reach hardware.

  5. 2027

    Go public

    Form plans an initial public offering in 2027, which would make it the first pure-play long-duration storage manufacturer on the public markets and the clearest test yet of whether investors will underwrite multi-day storage economics. Form selected JPMorgan and Jefferies as lead bookrunners on June 17, 2026, an early concrete step toward the listing.

03

Latest news1

  1. Form Energy raises $750M Series G to scale battery output

    Form Energy said on August 12 it closed a $750 million Series G led by T. Rowe Price, with participation from Sequoia Capital, Janus Henderson, Franklin Templeton, GE Vernova, Coatue and other existing and new investors, taking the company's total funding raised to more than $2 billion. The round funds continued manufacturing scale-up of Form's 100-hour iron-air batteries at its Weirton, West Virginia factory, where a nearly 300,000 square-foot expansion is already under construction, and follows the company's disclosure that its commercial order book has more than tripled to over 80 GWh on demand from AI data center operators including Google and Crusoe.

    TechCrunch FinSMEs

04

Products1

05

Key metrics

Employees
~1,000 company-wide

(West Virginia, Massachusetts and California); more than 450 at Form Factory 1 in Weirton

Est. annual revenue
Not disclosed

CEO Mateo Jaramillo said Form expects its first meaningful revenues in 2026 as the Minnesota pilot finishes and factory shipments begin, against an 80+ GWh order book whose large deliveries run from 2027 through 2029.

Storage duration
100 hours at rated power

roughly 25x a standard 4-hour lithium-ion system

Commercial pipeline

80+ GWh of projects under agreement, more than tripled from ~20 GWh in 2025; reconfirmed as of the August 2026 Series G raise. Factory output is allocated into late 2028 or 2029

First international deployment
Ballynahone Energy Storage

10 MW / 1 GWh iron-air project with FuturEnergy Ireland in County Donegal, targeted online 2029

Largest single project

300 MW / 30 GWh with Google and Xcel Energy - the largest battery project by energy capacity announced worldwide

Total funding raised

Over $2B, including a $750M Series G closed in August 2026, the final private round expected before a 2027 IPO

Series G valuation

About $1.75B pre-money, down from about $3B pre-money in the October 2024 Series F - a down round even as the commercial order book more than tripled. No later valuation has been published.

Form Factory 1

550,000 sq ft in Weirton, West Virginia, in production with more than 450 people on site; nearly 300,000 sq ft expansion under construction toward ~850,000 sq ft

2028 manufacturing target

500 MW / 50 GWh of annual capacity across 1M+ sq ft; current output already allocated into late 2028 or 2029

Utility and data-center customers
Google/Xcel

(300 MW / 30 GWh), Crusoe (12 GWh), FuturEnergy Ireland (10 MW / 1 GWh), Great River Energy (1.5 MW / 150 MWh, COD targeted end-2026), Georgia Power (15 MW / 1.5 GWh), Dominion Energy (8.94 MW Darbytown pilot), Lincoln Maine / Power Up New England (85 MW / 8.5 GWh, construction 2028), NYSERDA, California Energy Commission

Lincoln, Maine project

85 MW / 8,500 MWh at the former Lincoln Paper and Tissue mill; construction targeted 2028; nearly $150M in DOE grid-resilience funds; sized to power about 65,000 households

Latest debt facility
$270 million closed 21 Sept 2026

(revolver plus Section 45X tax-credit advance). Accordion can raise total credit under the facility to $1 billion; that ceiling is not committed drawn funding. Barclays lead; Citi, Jefferies, JPMorgan, RBC, Societe Generale, Stifel, Wells Fargo in syndicate.

Cambridge EIA-860M status (August 2026)

Plant 2038 generator BA1: status U, under construction <=50% complete; batteries; 1 MW nameplate; planned December 2027. Not operating.

Darbytown iron-air pilot
Not operating

August 2026 EIA-860M has no battery generator at Darbytown plant 7212 (four gas turbines only, OP). Form Energy share is 4.94 MW / 494 MWh beside 4 MW Eos; late-2026 target not met as of this inventory.

Form Factory 1 (homepage)

Homepage now says a one-million-square-foot Weirton plant employing over 500 people, versus earlier 550,000 sq ft / more than 450 language.

06

Operations & revenue

Operating status

Operational - factory running; Cambridge still EIA status U, Darbytown not operating

August 2026 EIA-860M Planned inventory lists Cambridge CT Hybrid plant 2038 generator BA1 as status U (under construction, less than or equal to 50 percent complete), batteries, 1 MW nameplate, planned operation December 2027. It is not on the Operating tab. Great River Energy's page still says operation by the end of 2025. Form's about page still calls Cambridge a commercial demonstration and says over 1,000 company-wide. Darbytown plant 7212 has no battery generator in the August 2026 Operating or Planned inventories. The 8.94 MW figure is the combined BESS-4 (4.94 MW Form Energy iron-air plus 4 MW Eos), not a single iron-air unit, and it has not reached operation. Homepage now says Form Factory 1 is one million square feet with over 500 people.

Revenue streams

  • Utility-scale multi-day storage systems

    Sales of iron-air battery systems to regulated utilities and cooperatives for renewable firming and winter reliability, including Great River Energy, Xcel Energy, Georgia Power and Dominion Energy, plus Form's first deployment outside the US - the 10 MW / 1 GWh Ballynahone project with FuturEnergy Ireland.

  • Data center capacity agreements

    Large multi-gigawatt-hour supply commitments to AI infrastructure buyers, now the largest part of the pipeline: 30 GWh for Google via Xcel and 12 GWh for Crusoe, with deliveries from 2027.

07

Track record

How past announced dates turned out.

2/3announced dates hit on time

  • 2 Hit
  • 1 Slipped
  • 0 Missed
  1. Hit

    Close the pre-IPO round of up to $500M

    Target Late 2026 · Resolved Aug 12, 2026

    Form closed a $750M Series G on August 12, 2026, led by T. Rowe Price, exceeding the up-to-$500M target and taking total funding raised past $2B. The company still expects this to be its last private round before a 2027 IPO.

  2. Slipped

    Bring the Cambridge, Minnesota iron-air project online by late 2025

    Target Late 2025 · Resolved Mar 24, 2026

    The 1.5 MW / 150 MWh project with Great River Energy did not reach operation in 2025. Form began delivering the system in early 2026 and now expects the full project to come online during 2026.

  3. Hit

    Start high-volume production at Form Factory 1

    Target 2025 · Resolved Mar 24, 2026

    Form confirmed it had launched production at the Weirton plant and commenced delivery of its first commercial system, moving iron-air from prototype to manufactured product. A nearly 300,000 square-foot expansion of the factory is now under construction.

08

Timeline14

  1. 2026

    1. EIA-860M August 2026 lists Cambridge BA1 as status U, planned December 2027

      The August 2026 EIA-860M Planned workbook lists Great River Energy's Cambridge CT Hybrid plant 2038 generator BA1 as batteries, status U (under construction, less than or equal to 50 percent complete), 1 MW nameplate, planned operation December 2027. The same plant's GT1 and GT2 remain operating. GRE's project page still says 1.5 MW and operation by the end of 2025. Form's about page still describes a commercial demonstration, not commercial operation.

    2. Closes $270M credit facility with 45X accordion

      On 21 September 2026 Form closed a $270 million credit facility combining a revolver and a tax-credit advance against Section 45X manufacturing credits. The tax-credit leg includes an accordion that can expand total credit under the facility to $1 billion. Barclays was sole structuring bank; Citi, Jefferies, JPMorgan Chase, RBC Capital Markets, Societe Generale, Stifel and Wells Fargo participated. Proceeds support Weirton scale-up and working capital. This is debt, not a new equity round.

    3. Weirton factory hiring sprint as production ramps

      On September 9, 2026 Form announced a Technician Hiring Sprint at Form Factory 1 for day and night shifts across maintenance, quality, process, controls and data roles. The company said it employs more than 450 people in Weirton as it expands production of 100-hour iron-air systems.

    4. Lincoln, Maine 85 MW / 8.5 GWh project slated to start in 2028

      In August 2026 Form hosted US Energy Secretary Chris Wright and Senator Susan Collins at the former Lincoln Paper and Tissue mill in Lincoln, Maine, the planned site of an 85 MW / 8,500 MWh iron-air system under the DOE-backed Power Up New England partnership. Construction is set to start in 2028, using cells built at Form Factory 1, with nearly $150M in federal grid-resilience funds. Form says the system is sized to power about 65,000 Maine households.

    5. Adds Wes Sloan as COO and Navneet Govil as CFO with Series G

      With the August 12, 2026 Series G close, Form expands its executive team. Wes Sloan joins as chief operating officer from Panasonic Energy of North America, where he was executive vice president of the Nevada battery operation, to lead manufacturing scale-up. Navneet Govil joins as chief financial officer as Form prepares the reporting and controls for a possible 2027 IPO.

    6. Pipeline triples past 80 GWh; first international project announced in Ireland

      Form Energy's contracted commercial portfolio more than triples to over 80 GWh, up from about 20 GWh in 2025, on the strength of the Google/Xcel and Crusoe agreements. The company also announces Ballynahone Energy Storage, a 10 MW / 1 GWh iron-air project with FuturEnergy Ireland in County Donegal, its first deployment outside the United States, targeted online in 2029.

    7. Production launched and first commercial system delivered

      Form confirms high-volume production is running at Form Factory 1 and that it has begun delivering the first commercial pilot system in Minnesota, with construction underway on a nearly 300,000 square-foot expansion of the Weirton plant.

    8. 12 GWh capacity agreement with Crusoe for AI data centers

      On March 24, 2026 Form and Crusoe announce a strategic capacity agreement for 12 GWh of multi-day storage to support AI data centers, with deliveries starting in 2027 and every system built at Form Factory 1. Form discloses more than 75 GWh of commercial projects under agreement.

09

Funding

$2.1Bdisclosed across 5 rounds with a stated amount

Cumulative disclosed raise · dated rounds

$1B$2B$3B202220232024202520262027$2.1B raised
  1. Series D

    Aug 2021

    $240M

    ArcelorMittal XCarb (lead), Breakthrough Energy Ventures, Temasek, The Engine, Coatue

  2. Series E

    Oct 2022

    $450M

    TPG Rise Climate (lead), existing investors

  3. Series F

    Oct 2024

    $405M

    T. Rowe Price and GE Vernova (co-leads), TPG Rise Climate, Breakthrough Energy Ventures, Capricorn, Coatue, Energy Impact Partners, The Engine Ventures, NGP, Temasek, GIC, Prelude Ventures

  4. Series G

    Aug 2026

    $750M (a down round: about $1.75B pre-money valuation, down from about $3B pre-money in the October 2024 Series F)

    T. Rowe Price (lead), Sequoia Capital, Janus Henderson, Franklin Templeton, PEAK6 Investments, Prelude Ventures, Engine Ventures, TPG Rise Climate, Capricorn's Technology Impact Funds, Breakthrough Energy Ventures, Dustin Moskovitz and Cari Tuna, Gigascale Capital, Coatue, Energy Impact Partners, NGP, GE Vernova, Blindspot Ventures, M&G Catalyst Fund

  5. Credit facility (debt)

    Sept 2026

    $270M closed; accordion up to $1B total credit

    Barclays (sole structuring bank); Citi, Jefferies, JPMorgan Chase, RBC Capital Markets, Societe Generale, Stifel, Wells Fargo
