Voyager Technologies logo

Voyager Technologies

PublicFounded 2019🇺🇸Denver, Colorado
CEO

Dylan Taylor

Data verified as of Aug 29, 2026

Summary

Voyager Technologies is a Denver-based defense-technology and space-infrastructure company best known for leading Starlab, the international joint venture building a commercial successor to the International Space Station. Founded in October 2019 by Dylan Taylor as Voyager Space Holdings, the company grew by rolling up twelve space and defense firms - including Altius Space Machines and Pioneer Astronautics (2020), The Launch Company, Valley Tech Systems and Nanoracks (2021), Space Micro (2022), ZIN Technologies (2023), and Estes Energetics, ExoTerra Resource and LEOcloud (2025). Through Nanoracks it owns the Bishop Airlock, the first and only permanent commercial module on the ISS, operating since December 2020. Starlab won a $160M NASA Commercial LEO Destinations award in December 2021 (later raised to $217.5M) and evolved into Starlab Space LLC, a US-led JV with Airbus, Mitsubishi Corporation and MDA Space, with Palantir supplying station software, Hilton designing crew quarters and Northrop Grumman providing Cygnus resupply. The single-launch, 8-meter-class station - with roughly half the ISS's pressurized volume - is contracted to fly on SpaceX's Starship, now targeted for 2029, and completed its Commercial Critical Design Review with NASA in February 2026, clearing the way for flight manufacturing. Voyager rebranded to Voyager Technologies in early 2025 to emphasize national security and went public on NYSE in June 2025, raising $382.8M and briefly touching a ~$3.8B valuation. Its Defense & National Security segment - solid and electric propulsion, energetics, signals intelligence and communications - is its fastest-growing business and put it on the Anduril-led team named among the Space Force's Golden Dome space-based-interceptor awardees in April 2026. On July 13, 2026 it closed its acquisition of Pittsburgh lunar-lander developer Astrobotic Technology ($162M cash and stock plus up to $129M in earnouts and $9M assumed debt), rebranding the unit Voyager Lunar Systems under continuing CEO John Thornton, and the same day disclosed a roughly $298M NASA Commercial Lunar Payload Services task order won under the deal - funding the Peregrine-2 lander to carry three NASA payloads to the Moon's Gruithuisen Domes in 2028 - adding an end-to-end lunar business alongside space stations and defense; the nearer-term proof point is Griffin-1, an infrastructure-class lander carrying 10 NASA/ESA/commercial payloads that is now in environmental testing at NASA JPL ahead of a Falcon Heavy launch no earlier than November 30, 2026. As of August 28, 2026 Voyager traded around a $2.1B market cap (down from a post-earnings peak near $2.55B in mid-August), posted $166.4M of 2025 revenue (net loss $116.1M), held $585.5M of total liquidity as of June 30, 2026, and had closed an upsized $250M J.P. Morgan-led credit facility on July 6, 2026. Q2 2026 results reported August 3 showed record revenue of $52.7M (up 51% sequentially), record bookings of $113.0M, and a record $335.5M backlog, prompting Voyager to raise 2026 revenue guidance to $275-305M from a prior $230-255M range; Starlab separately has signed over $500M of commercial reservations ahead of launch. Since then Voyager has added an August 4 Raytheon SM-3 missile-interceptor propulsion contract and an August 10 Space Force space-to-space communications contract to its Defense & National Security backlog. NASA's CLD Phase 2 industry-feedback window closed July 27, 2026 as scheduled; as of August 29, 2026 NASA had not yet issued the final RFP it had been tracking toward late August, with an award still expected in early-to-spring 2027.

/ Recent News

View all →
  • View all news

    Browse the daily archive

Main Products

Starlab

Starlab

In Development

Next-generation commercial space station developed by Starlab Space, the Voyager-led JV with Airbus, Mitsubishi Corporation and MDA Space. The ~8-meter-diameter, two-deck station launches complete in a single SpaceX Starship flight - no on-orbit assembly - and hosts a continuous crew of four with ISS-equivalent payload capability, an MDA SKYMAKER robotic arm, Palantir-built AI/data infrastructure and Hilton-designed crew quarters. Completed NASA Commercial Critical Design Review in February 2026; targeting a 2029 launch.

CCDR complete (Feb 2026); transitioning to manufacturing, fabrication, testing and assembly ahead of a targeted 2029 Starship launch, pending NASA CLD Phase 2 outcome

Pressurized volume~450 m³ (about half the ISS) in one launch
Crew capacity4 continuous, 8 during handover
Payload capacity13 internal payload platforms (130 MDLE-equivalent) plus two external platforms
Commercial reservations signedOver $500M, approaching $600M (as of Q2 2026 earnings, Aug 3, 2026)

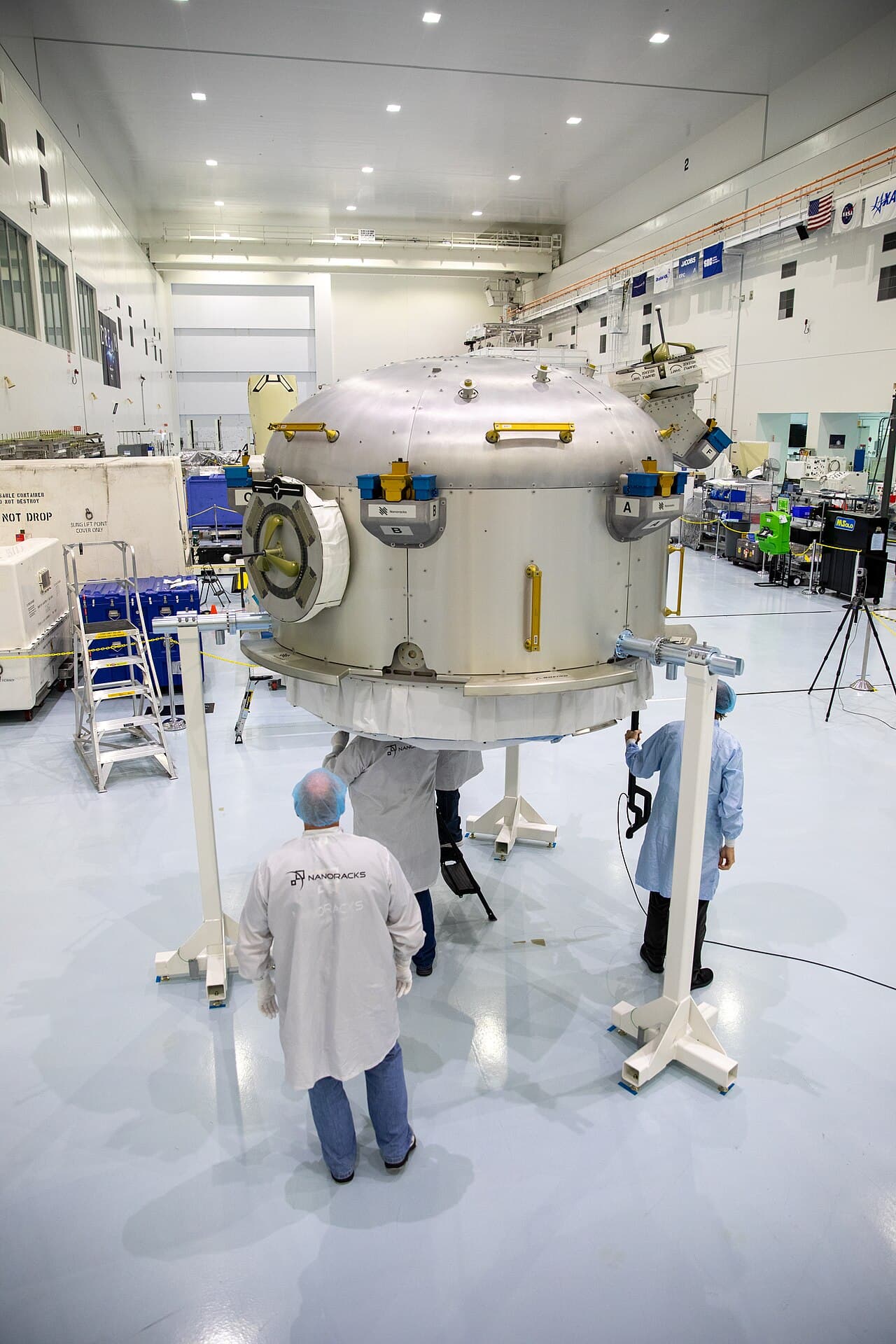

Bishop Airlock

Bishop Airlock

Operational

The first and only permanent commercially owned module on the International Space Station, built by Nanoracks (now Voyager) with Thales Alenia Space and Boeing. The bell-shaped, ~4 m³ airlock - five times the capacity of the station's government airlock - deploys CubeSats and external payloads, hosts experiments and ejects trash, and has operated since its December 2020 arrival on SpaceX CRS-21.

Installed on the ISS Tranquility module December 19, 2020; in commercial service for NASA and private payload customers

Internal volume~4 m³, 5x the capacity of the ISS government airlock
In service sinceDecember 2020 (launched on SpaceX CRS-21)

A commercial lunar lander acquired with the July 13, 2026 close of the Astrobotic acquisition, flying NASA payloads under the Commercial Lunar Payload Services program. Peregrine Mission One launched January 8, 2024 on the maiden flight of ULA's Vulcan Centaur, but a propellant-system valve failure caused a critical fuel leak shortly after separation; unable to attempt a soft landing, the spacecraft was directed to reenter and burn up in Earth's atmosphere on January 18, 2024. Peregrine-2, awarded a ~$298M NASA CLPS task order, will carry three NASA payloads to the Moon's Gruithuisen Domes.

Peregrine-2 in development for a ~2028 landing at the Gruithuisen Domes under the $298M NASA CLPS task order

Payload capacity (Peregrine-2)175 kg (386 lb)
NASA CLPS task order (Peregrine-2)~$298M

An infrastructure-class lunar lander acquired with the July 13, 2026 close of the Astrobotic acquisition, built for NASA's now-cancelled VIPER rover mission and repurposed as Griffin Mission One. Griffin-1 will carry 10 NASA, ESA and commercial payloads - including Venturi Astrolab's FLEX Lunar Innovation Platform (FLIP) rover - to the Nobile Crater region near Mons Mouton at the lunar south pole, delivering the largest commercial payload ever sent to the Moon and demonstrating Griffin's ability to carry Moon Base cargo such as rovers, science instruments and solar power plants.

Griffin-1 completed mass-properties testing and is undergoing environmental testing (vibration, thermal-vacuum) at NASA's Jet Propulsion Laboratory, targeting a Falcon Heavy launch from Kennedy Space Center no earlier than November 30, 2026

Payload manifest10 payloads (NASA, ESA and commercial customers)
Launch vehicle and targetSpaceX Falcon Heavy from Kennedy Space Center, NET November 30, 2026

What's Next

Win a NASA CLD Phase 2 award

NASA released the Phase 2 draft RFP on July 6, 2026 and closed the industry feedback window on July 27 as scheduled; Administrator Jared Isaacman said the response confirmed industry believes it can meet the timelines and that a viable marketplace exists, and NASA will proceed with its original firm-fixed-price, full-and-open-competition strategy. CEO Dylan Taylor has publicly pushed NASA for relaxed Phase 2 requirements, warning overly robust requirements could keep companies from building stations on time and on budget, and expects elements to be relaxed in the final RFP. As of August 29, 2026 NASA had not yet issued that final RFP, which it had been tracking toward late August; Voyager's Q2 2026 earnings call still pointed to proposal submissions in mid-to-late fall 2026 and a selection in early 2027. NASA plans at least two early development contracts for commercial space stations before a later down-select. Winning is the pivotal catalyst for Starlab's multi-billion-dollar opportunity.

Early 2027

Launch Griffin-1 to the Moon's south pole

Griffin-1, the infrastructure-class lander Astrobotic (now Voyager Lunar Systems) built for NASA's now-cancelled VIPER rover, carries 10 NASA, ESA and commercial payloads - including Venturi Astrolab's FLEX Lunar Innovation Platform (FLIP) rover - to the Nobile Crater region near Mons Mouton at the lunar south pole, delivering the largest commercial payload ever sent to the Moon. Having completed mass-properties testing, the lander is now undergoing environmental (vibration and thermal-vacuum) testing at NASA's Jet Propulsion Laboratory. The mission is targeted to launch on a SpaceX Falcon Heavy from Kennedy Space Center no earlier than November 30, 2026, a nearer-term proof point for Voyager's lunar-delivery business than the 2028-targeted Peregrine-2 mission.

NET November 30, 2026

Integrate Astrobotic and execute Peregrine-2 lunar delivery

With the Astrobotic acquisition closed on July 13, 2026, the unit has been rebranded Voyager Lunar Systems (Astrobotic CEO John Thornton remains in charge) and its Pittsburgh Moon Base folded into Voyager's lunar business. The nearer-term proof point is Griffin-1 (see separate next step, NET Nov 30, 2026), now in environmental testing at NASA JPL; Peregrine-2 - the ~$298M NASA CLPS task order delivering three NASA payloads to the Gruithuisen Domes in 2028 - remains earlier in development. Watch for further CLPS task-order wins under NASA's Moon Base initiative and Peregrine-2 hardware and manifest updates.

2028

Move Starlab into flight-hardware manufacturing

Following the February 2026 Commercial Critical Design Review - the 28th NASA milestone - Starlab transitions from design validation to manufacturing, fabrication, testing and assembly of the flight station. The program has now signed over $500M of commercial reservations (approaching $600M) ahead of launch, and NASA Space Act Agreement milestone payments (~$211M of the $217.5M awarded received through Q2 2026) are moderating as the program shifts toward Phase 2 commercialization. Watch for structural test article and long-lead hardware milestones.

2026-2027

Hit raised FY2026 revenue guidance

After a record Q2 2026 (revenue $52.7M, up 51% sequentially; bookings $113.0M; backlog $335.5M), management raised full-year 2026 revenue guidance again on August 3 to $275-305M (66-84% YoY growth over 2025's $166.4M), from a prior $230-255M range - reflecting the completed Astrobotic acquisition and accelerating Defense & National Security demand. Q2 net loss was $(46.5)M and Adjusted EBITDA a loss of $(38)M, which management frames as an investment year; CFO guidance points to gross margins of roughly 17% in Q3 stepping up to the low-20s% later. No Q3 2026 results had been reported as of August 29, 2026; whether the back half of the year lands within the raised range, and whether losses narrow, is the next test.

Early 2027

Launch Starlab on Starship

The complete station is contracted to launch in a single SpaceX Starship flight, currently targeted for 2029 - timed to provide continuous LEO access before the ISS is retired around 2030.

2029

Track Record

2 of 4 announced dates hit · 2 slipped

Close the Astrobotic acquisition

Target July 2026 · Resolved Jul 13, 2026

Voyager completed the acquisition of lunar-lander maker Astrobotic on July 13, 2026 - $162M in cash and stock plus up to $129M in earnouts and $9M assumed debt - on the timeline signaled at announcement, and the same day disclosed a ~$298M NASA CLPS task order (Peregrine-2 to the Gruithuisen Domes in 2028) won under the deal.

Hit

Starlab launch in 2028

Target 2028 · Resolved Jul 8, 2026

The 2028 launch target communicated through 2024-2025 slipped again: 2026 reporting around NASA's CLD Phase 2 draft RFP puts Starlab's launch in 2029.

Slipped

Complete IPO on NYSE

Target June 2025 · Resolved Jun 11, 2025

Priced at $31 on June 10, 2025 and began trading as VOYG on June 11, raising $382.8M with an 84% first-day pop to $57.13.

Hit

Starlab operational in orbit by 2027

Target 2027 · Resolved Jan 31, 2024

The October 2021 announcement targeted a free-flying station by 2027, but by the time Starlab booked its Starship launch in January 2024 the target had moved to 2028.

Slipped

Operations & Revenue

StatusPublic; defense scaling while Starlab awaits NASA Phase 2

Voyager trades on the NYSE with three reporting segments plus a new lunar business: Defense & National Security (its growth engine, boosted by Golden Dome interceptor work with Anduril - $84.3M in Golden Dome-related awards across multiple customers, a May 26, 2026 DARPA 'Burn n' Go' Phase 2 contract ($16.5M) for tailorable solid-rocket-motor tech, a July 9, 2026 agentic-AI spectrum-operations platform contract, a July 20, 2026 Sandia National Laboratories mission-management contract for the 'Big Boy' ISS demonstration flying via the Bishop Airlock in 2027, an August 4, 2026 Raytheon contract supplying propulsion and divert/attitude-control systems for the SM-3 missile interceptor, and an August 10, 2026 Space Force Space Systems Command contract for space-to-space communications), Space Solutions (Bishop Airlock ISS services - including a February 2026 four-year, $24.5M NASA Johnson Space Center IDIQ for full-service ISS mission management - in-space propulsion, and space science), and Starlab, which has now signed over $500M of commercial reservations (approaching $600M) even before launch. On July 13, 2026 Voyager closed its acquisition of lunar-lander maker Astrobotic ($162M cash and stock, up to $129M earnouts, $9M assumed debt), rebranding the unit Voyager Lunar Systems (Astrobotic CEO John Thornton stays on to lead it) and adding commercial lunar delivery and lunar power to the portfolio; Astrobotic's Griffin-1 lander, carrying 10 NASA/ESA/commercial payloads to the lunar south pole, is undergoing environmental testing at NASA JPL ahead of a launch no earlier than November 30, 2026, while the ~$298M NASA CLPS-funded Peregrine-2 mission targets the Gruithuisen Domes in 2028. Q2 2026 results reported August 3 showed record quarterly revenue of $52.7M (up 51% sequentially), record bookings of $113.0M (2.1x book-to-bill), and a record $335.5M backlog; Voyager raised full-year 2026 revenue guidance to $275-305M (66-84% YoY growth) from a prior $230-255M range, and closed the quarter with $585.5M of total available liquidity. Starlab completed its Commercial Critical Design Review in February 2026 and is moving toward flight manufacturing; NASA's CLD Phase 2 industry-feedback window closed July 27, 2026 as scheduled, and as of Aug 29, 2026 NASA has not yet issued the final RFP it had been tracking toward late August, with an award still expected in early-to-spring 2027.

Revenue Streams

Defense & National Security

Solid-fuel and electric propulsion, energetics, radiation-hardened electronics, signals intelligence, communications and AI-powered edge computing for defense customers - the fastest-growing segment (63% YoY growth in Q4 2025), including work on the Anduril-led Golden Dome space-based interceptor team, a spot on the Air Force's $46B agile acquisition contract vehicle, a May 26, 2026 DARPA 'Burn n' Go' Phase 2 contract ($16.5M) for tailorable solid-rocket-motor technology, a July 9, 2026 agentic-AI spectrum-operations platform contract, a July 20, 2026 Sandia National Laboratories mission-management contract for the 'Big Boy' ISS demonstration, an August 4, 2026 Raytheon contract to supply solid controllable throttleable propulsion and divert/attitude control systems for the SM-3 missile-defense interceptor family, and an August 10, 2026 Space Force Space Systems Command contract to develop space-to-space communication capabilities.

Space Solutions

ISS commercial services through the Bishop Airlock (payload hosting, satellite deployment, trash disposal), in-space electric propulsion systems, and space science and exploration hardware drawing on Nanoracks and ZIN Technologies heritage - anchored by a new four-year, $24.5M NASA Johnson Space Center IDIQ contract (Feb 9, 2026) for full-service ISS mission management, building on more than 50 task orders executed under the prior JSC services contract.

Starlab (NASA milestones today, station services later)

Milestone payments under the $217.5M NASA Commercial LEO Destinations Space Act Agreement fund development today (~$211M received through Q2 2026, with milestone funding now moderating as the program shifts toward Phase 2 commercialization); Starlab has already signed over $500M of commercial reservations ahead of launch, and after launch Starlab Space (majority-owned JV) would sell astronaut time, payload racks and research services to NASA, international agencies and commercial customers as an ISS replacement.

Lunar Delivery & Infrastructure (Voyager Lunar Systems, formerly Astrobotic)

Added with the July 13, 2026 close of the Astrobotic acquisition and rebranded Voyager Lunar Systems (Astrobotic CEO John Thornton continues to lead it): commercial lunar payload delivery via the Griffin and Peregrine landers under NASA's Commercial Lunar Payload Services program. Griffin-1 - carrying 10 NASA, ESA and commercial payloads, the largest commercial payload ever sent to the Moon - is in environmental testing at NASA JPL ahead of a launch no earlier than November 30, 2026; Peregrine-2 carries a ~$298M NASA CLPS task order to the Gruithuisen Domes in 2028. The unit also develops lunar power systems (LunaGrid), planetary mobility, and reusable-rocket work.

Key Metrics

Employees

~800 across 14 locations (as of Dec 31, 2025, per the FY2025 10-K)

Est. Annual Revenue

$166.4M (FY2025); Q2 2026 revenue $52.7M, up 51% sequentially; 2026 guidance raised to $275-305M

Market cap

~$2.1B (~$34-36/share as of Aug 28, 2026; down from the ~$2.55B post-earnings peak in mid-August as shares gave back some of the Q2 pop)

Revenue (FY2025)

$166.4M (+15% YoY)

Q2 2026 Net Loss

$(46.5)M ($(0.79)/share); Adjusted EBITDA loss of $(38)M - management frames 2026 as an investment year, with losses driven by scaling Defense & National Security and Starlab

2026 revenue guidance

$275M-$305M (raised with Q2 2026 results, from a prior $230M-$255M; 66-84% YoY growth); no Q3 2026 update yet as of Aug 29, 2026

Total backlog

$335.5M (Q2 2026, record)

NASA Starlab Space Act Agreement

$217.5M awarded ($160M in 2021 + $57.5M in 2024); ~$211M received via milestone payments through Q2 2026 (a $4M milestone completed in the quarter), with milestone funding now naturally moderating as the program shifts from Phase I development toward Phase 2 commercialization

Starlab commercial reservations

Over $500M signed, approaching $600M as of the Q2 2026 earnings call (Aug 3, 2026) - government and commercial customer commitments ahead of a station that has not yet launched

Liquidity

$585.5M total available liquidity as of June 30, 2026: $373.4M cash and cash equivalents plus $212.1M of available revolver capacity under the $250M J.P. Morgan-led credit facility (upsized July 6, 2026, with an accordion for up to $150M more)

Starlab target launch

2029, single launch on SpaceX Starship

Timeline

2026Wins $24.5M NASA Johnson Space Center mission-management IDIQ

On February 9, 2026 Voyager wins a new four-year, $24.5M ceiling Indefinite Delivery/Indefinite Quantity contract from NASA's Johnson Space Center for full-service ISS mission management - payload integration, mission operations, safety and compliance, and post-mission closeout - building on the more than 50 task orders Voyager executed under its prior JSC services contract, including Bishop Airlock waste-deployment operations.

2026Starlab completes NASA Commercial Critical Design Review

On February 23, 2026 Starlab completes its Commercial Critical Design Review with NASA - the 28th milestone under its Space Act Agreement - confirming the design is mature and executable and marking the transition from design to manufacturing, fabrication, testing and assembly.

2026Named in Space Force Golden Dome interceptor awards

On April 24, 2026 the Space Force reveals up to $3.2B in contracts to 12 companies to develop Golden Dome space-based interceptors. Voyager participates on the Anduril-led team alongside Impulse Space and K2 Space, contributing energetics, propulsion, and digital avionics and communications technologies.

2026Wins $16.5M DARPA 'Burn n' Go' Phase 2 contract

On May 26, 2026 Voyager is awarded a 20-month, $16.5M DARPA Burn n' Go Phase 2 contract to develop and validate propellant-embedded control technology giving solid rocket motors tailorable, post-manufacturing thrust control, culminating in hot-fire demonstrations - adding a new propulsion R&D line to the Defense & National Security segment.

2026Agrees to acquire Astrobotic for up to $300M

On June 2, 2026 Voyager announces the acquisition of Pittsburgh lunar-lander company Astrobotic Technology - $162M in cash and stock plus up to $129M in earnouts and $9M of assumed debt - expanding into commercial lunar delivery and lunar power. The deal was expected to close by early July 2026.

2026Closes upsized $250M J.P. Morgan-led credit facility

On July 6, 2026 Voyager amends its May 2025 credit agreement with JPMorgan Chase, lifting total lender commitments by $50M to $250M and revising covenants, while preserving the ability to request up to $150M more through an accordion feature. CFO Phil De Sousa: 'We continue to maintain a fortress balance sheet.'

2026NASA releases CLD Phase 2 draft RFP

After pausing the Phase 2 acquisition in January 2026 to revisit requirements, NASA releases a draft request for proposals on July 6, 2026, planning at least two early development contracts for commercial space stations. Industry feedback is due July 27, positioning Starlab for the decisive ISS-replacement competition.

2026Closes Astrobotic acquisition, rebrands it Voyager Lunar Systems, wins ~$298M NASA lunar contract

On July 13, 2026 Voyager completes its acquisition of Pittsburgh-based lunar company Astrobotic Technology, first announced June 2 - paying $162M in cash and stock plus the assumption of $9M in debt, with up to $129M in earnouts tied to performance milestones - and rebrands the unit Voyager Lunar Systems, with Astrobotic's Moon Base headquarters becoming the center of Voyager's lunar program and longtime Astrobotic CEO John Thornton staying on to lead it. The same day Voyager disclosed that Astrobotic had been awarded a roughly $298M NASA Commercial Lunar Payload Services task order (announced June 30, after the deal was signed) for the Peregrine-2 mission, which will deliver three NASA payloads to the Gruithuisen Domes in 2028 to study the lunar radiation environment, analyze landing-engine plume interactions, and establish a long-term navigational reference point, under NASA's Artemis-aligned Moon Base initiative.

2026Wins Sandia National Laboratories mission-management contract

On July 20, 2026 Voyager is awarded a contract to provide end-to-end mission management - experiment design, payload integration, safety review, manifest and mission planning, and on-orbit operations - for Sandia National Laboratories' 'Big Boy' demonstration, which will fly to the ISS in 2027 integrated with Voyager's NEL external payload platform on the Bishop Airlock.

2026Q2 2026 results: record backlog, guidance raised again

Voyager reported record Q2 2026 revenue of $52.7 million (up 51% sequentially), record bookings of $113.0 million (2.1x book-to-bill), and a record $335.5 million backlog on August 3, 2026. The company raised full-year 2026 revenue guidance to $275-305 million from a prior $230-255 million range, citing accelerating defense demand, the completed Astrobotic acquisition, and $84.3 million in Golden Dome-related awards; shares jumped more than 13% after hours.

2026Wins Raytheon contract for SM-3 propulsion technology

On August 4, 2026 Voyager is awarded a contract by Raytheon, an RTX business, to advance propulsion technologies for the Standard Missile-3 (SM-3) interceptor family. Voyager will supply its solid controllable throttleable propulsion technology and divert, attitude and control systems (DACS) - precision subsystems that enable accuracy during the exo-atmospheric midcourse phase of flight - adding a new missile-defense propulsion line to its Defense & National Security segment.

2026Wins Space Force contract for space-to-space communications

On August 10, 2026 Voyager is awarded a U.S. Space Force Space Systems Command contract to develop space-to-space communication capabilities supporting a resilient data transport architecture for the Department of Defense. Voyager will develop a flight-ready waveform design for a variety of orbits and perform an on-orbit communication demonstration, extending its Defense & National Security segment into proliferated LEO data-relay technology.

2026Griffin-1 lander enters environmental testing at NASA JPL

Following mass-properties testing, Griffin-1 - Voyager Lunar Systems' infrastructure-class lander carrying 10 NASA, ESA and commercial payloads to the lunar south pole - is shipped to NASA's Jet Propulsion Laboratory for environmental testing (vibration and thermal-vacuum) simulating launch and the cislunar journey, a critical step toward a Falcon Heavy launch no earlier than November 30, 2026 as part of NASA's Moon Base cargo program.

2025Rebrand to Voyager Technologies

Voyager Space rebrands as Voyager Technologies in early 2025 to reflect an expanded focus on national security alongside its space business. The company organizes around Defense & National Security, Space Solutions and Starlab segments.

2025IPO on NYSE raises $382.8M

Voyager prices its IPO at $31 per share and begins trading on the NYSE as VOYG on June 11, 2025, selling 14,200,645 shares for $382.8M. Shares close their first day up more than 80% at $57.13, valuing the company as high as ~$3.8B.

2024Starlab Space LLC finalized; NASA funding grows to $217.5M; Starship booked

The Voyager-Airbus JV Starlab Space LLC closes on January 9, 2024, and NASA adds $57.5M to the Space Act Agreement (total $217.5M) on January 5. On January 31 Starlab books SpaceX's Starship to launch the entire station in a single flight.

2024Mitsubishi and MDA Space become Starlab equity partners

Mitsubishi Corporation joins the Starlab joint venture as an equity owner in April 2024, followed by Canada's MDA Space on May 29, 2024, which contributes SKYMAKER robotic arms and external robotics. Palantir (station software/AI, February 2024), Hilton (crew quarters, 2022) and Northrop Grumman (Cygnus resupply, 2023) round out the partner network.

2023Airbus joins Starlab; transatlantic JV formed

Airbus Defence and Space joins the Starlab program in January 2023, replacing Lockheed Martin and shifting the design from inflatable to a rigid metallic 8-meter-class module. Voyager and Airbus formalize a joint venture agreement in August 2023 after passing NASA's Systems Requirements Review in June.

2021Nanoracks acquisition anchors the roll-up

Voyager acquires a majority stake in X.O. Markets, parent of ISS-services leader Nanoracks, in May 2021 - its marquee acquisition among twelve since 2019, including Altius Space Machines and Pioneer (2020), The Launch Company and Valley Tech Systems (2021), Space Micro (2022) and ZIN Technologies (2023).

2021NASA awards Starlab $160M CLD agreement

In December 2021 NASA selects the Nanoracks/Voyager-led Starlab team for a $160M Commercial LEO Destinations Space Act Agreement - the largest of three awards, ahead of Blue Origin's Orbital Reef ($130M) and Northrop Grumman ($125.6M). Starlab is proposed as a free-flying successor to the ISS.

2020Bishop Airlock reaches the ISS

The Nanoracks Bishop Airlock, the first permanent commercial module on the International Space Station, launches on SpaceX CRS-21 on December 6, 2020 and is berthed to the Tranquility module on December 19. Voyager acquires Bishop's owner Nanoracks the following year.

2019Founded as Voyager Space Holdings

Dylan Taylor founds Voyager Space Holdings in Denver in October 2019 as a holding company to consolidate NewSpace firms. The strategy is growth by acquisition across space infrastructure and services.

Funding

RoundDateAmountInvestorsSource
Growth roundFeb 2023$80.2MNewSpace Capital, Midway Venture Partners, Industrious Ventures, Seraphim Space
IPO (NYSE: VOYG)Jun 2025$382.8MPublic market investors (14,200,645 shares at $31.00; first-day close $57.13, ~$3.8B valuation)
